Construction at Bethlehem Steel Corp., San Francisco

Bethlehem Steel
Picture is from the Bethlehem Steel Archives

Bethlehem Steel
Picture is from Bethlehem Steel Archives

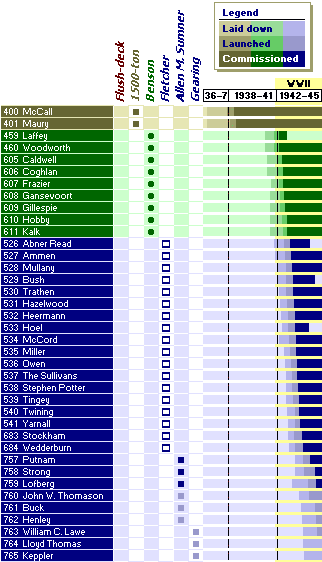

Build Schedule Bethlehem Steel
Schedule is from Bethlehem Steel Archives
